How to Build a Manganese Processing Plant and What is the Cost?



If you want to know more details about equipment, solutions, etc, please click the button below for free consultation, or leave your requirements!

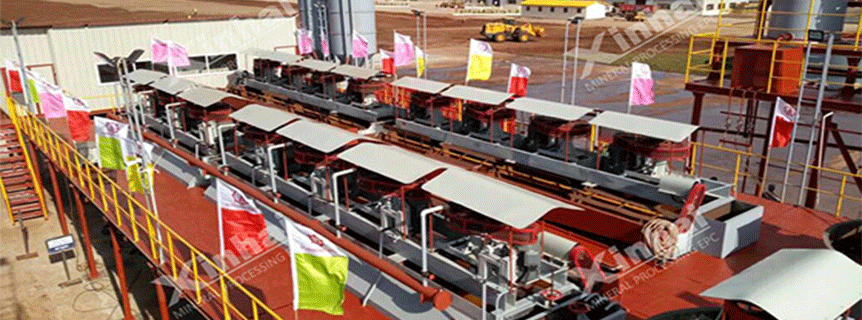

Uganda 720TPD Manganese Processing Plant
Building a manganese processing plant involves several stages, and costs can vary significantly based on the scale, location, technology, and local infrastructure. Here’s a breakdown:
01Key Components of a Manganese Processing Plant:
Back1. Raw Material Handling: Systems for receiving, unloading, and storing manganese ore.
2. Crushing and Screening: Reduces the size of the ore and separates it by size.
3. Grinding and Milling: Further reduces ore size for processing.

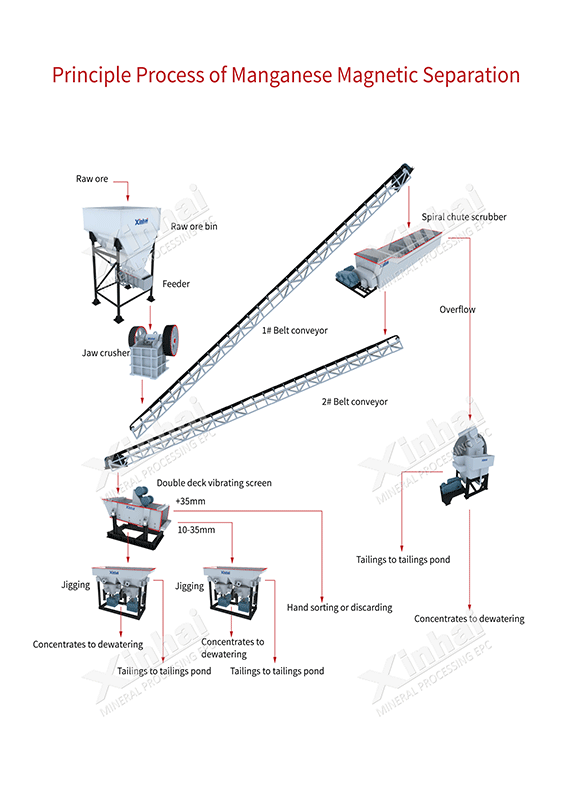

4. Beneficiation: Techniques like gravity separation, flotation, magnetic separation, or hydrometallurgy to concentrate manganese.
5. Leaching (if required): Dissolves manganese from ore using acid or alkaline solutions.
6. Tailings Management: Handling and disposal of waste material.
7. Utilities and Support Systems: Water treatment, power supply, and maintenance facilities.
02Cost Factors:
Back1. Raw Material Handling:
Purpose: Efficiently receive, store, and transport manganese ore.
Equipment: Hoppers, conveyors, stackers, reclaimers.
Cost:
Equipment: $500,000 - $2 million
Installation and civil works: $1 million - $3 million
Factors Affecting Cost: Ore grade and moisture content, distance from mining site.
2. Crushing and Screening:
Purpose: Reduce ore size and separate based on particle size.
Equipment: Jaw crushers, impact crushers, vibrating screens.
Cost:
Equipment: $1 million - $5 million
Installation: $500,000 - $1 million
Factors Affecting Cost: Desired throughput, hardness of the ore.
3. Grinding and Milling:
Purpose: Further size reduction to liberate manganese minerals.
Equipment: Ball mills, rod mills, SAG mills.
Cost:
Equipment: $2 million - $10 million
Installation: $1 million - $3 million
Factors Affecting Cost: Ore hardness, required particle size.
4. Beneficiation:
Purpose: Increase manganese concentration.
Techniques:
Gravity separation (jigging, shaking tables).
Magnetic separation.
Flotation (froth flotation cells).
Cost:
Gravity/Flotation Equipment: $3 million - $8 million
Installation: $1 million - $2 million
Factors Affecting Cost: Ore composition, desired purity.
5. Leaching (if required):
Purpose: Extract manganese using acid or alkali.
Equipment: Leach tanks, agitators, filtration systems.
Cost:
Equipment: $5 million - $15 million
Installation: $2 million - $5 million
Factors Affecting Cost: Choice between acid leaching and alkaline leaching, ore characteristics.
6. Tailings Management:
Purpose: Safe disposal of waste material.
Equipment: Tailings dams, thickening tanks.
Cost:
Infrastructure: $2 million - $10 million
Maintenance: $1 million - $3 million annually
Factors Affecting Cost: Local environmental regulations.
7. Utilities and Support Systems:
Purpose: Power, water, and maintenance support.
Equipment: Power generation, water treatment plants.
Cost:
Utilities setup: $5 million - $20 million
Ongoing operational costs: $2 million - $5 million per year
Factors Affecting Cost: Remote location, energy efficiency.
8. Project Management, Licensing, and Contingency:
Project Management: $2 million - $5 million
Licensing and Compliance: $1 million - $3 million
Contingency: Typically 10-20% of total project cost.
Example Cost Calculation (Medium-Scale Plant):
Total CAPEX: $50 million - $100 million
Total OPEX (per year): $20 million - $50 million
Payback period: Typically 5-7 years, depending on production rates and manganese prices.
03Summary:
BackTo build a manganese processing plant, several key components are required, including raw material handling, crushing and screening, grinding and milling, beneficiation, leaching (if applicable), smelting, electrolytic processing (if needed), tailings management, and utilities. The cost of constructing such a plant varies from $5 million to $500 million significantly based on its scale and complexity:
Small-Scale Plant: $5 - $20 million (suitable for pilot or low-capacity operations).
Medium-Scale Plant: $50 - $100 million (typical capacity of 20,000 - 50,000 tonnes per annum).
Large-Scale Plant: $100 - $500 million (high-capacity with advanced processing and smelting).
The total cost also depends on factors such as location, technology, infrastructure, and compliance requirements.
